Combine Hydro Test System

In hydro test applications where high volume and high pressure are required in a short time, and testing is frequent, a Combine Hydro Test System offers a reliable, fast, and cost-effective solution.

System Configuration

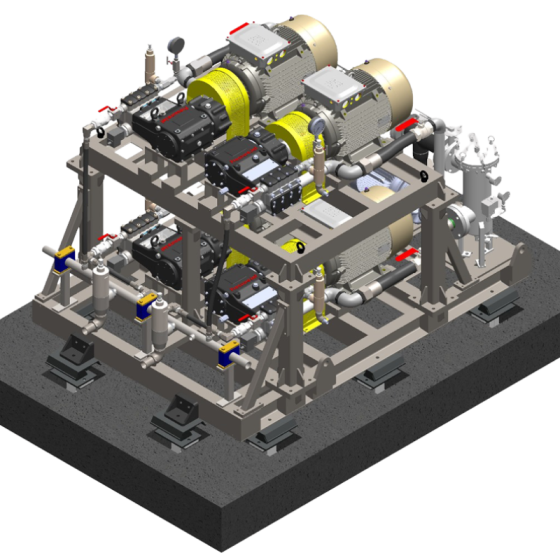

A Combine Hydro Test System typically consists of two or more pumps:

  1. High-flow, low-pressure filling pump

  2. Medium-flow, medium-pressure pump

  3. Low-flow, very high-pressure pump (optional in some cases)

This modular arrangement ensures that water is delivered efficiently, with the right flow and pressure at every stage of the test.


Why Use a Combine Hydro Test System?

Example Scenario:

  • Tank volume: 10,000 liters

  • Test pressure: 500 bar

  • Available time: 10 minutes

Challenge:
A single pump capable of delivering 1,100 LPM at 580 bar would require 1,700 HP, which is neither feasible nor cost-effective.

Solution with a Combine Hydro Test System:

  1. High-flow, low-pressure filling stage:

    • Use a submersible, vertical turbine, or high-flow low-head pump (1,400 LPM at 6 bar, ~40 HP) to fill the tank in ~7 minutes.

  2. Medium-flow, medium-pressure stage:

    • A medium-flow pump (500 LPM at 60 bar, ~75 HP) feeds water and starts pressurizing the tank.

    • The high-flow filling pump continues to feed water simultaneously for ~5 minutes 20 seconds.

  3. Low-flow, high-pressure stage:

    • After the tank reaches ~60 bar, the high-pressure, low-volume pump (30 LPM at 500 bar, ~40 HP) is activated.

    • This pump pressurizes the remaining volume (~60 liters) to 500 bar within 2 minutes.

Result:

  • Total test time: ~8 minutes 20 seconds

  • Maximum connected load: <120>

  • Total cost: Much lower than a single 210 HP, high-pressure pump

  • Mobility: Easy transport and setup of multiple skid-mounted pumps


Key Advantages of Combine Hydro Test System

  1. Lower connected load – Efficient use of power at every stage

  2. Cost-effective – Total pump cost is significantly lower than a single high-power unit

  3. Fast and reliable – Achieves high-pressure testing within short time frames

  4. Flexible and modular – Easy to transport and deploy multiple skid-mounted pumps


Combine Hydro Test System – Optimized flow, precise pressure, and maximum efficiency for high-volume hydro testing.
